SCHEDULE
Planned Schedule
- Sensor/EMG: Circuit set-up by 10/15, working by 10/29
- Motor/pneumatics: 10/15
- Mechanical System: prototype 10/29, working Nov 3
- Safeties (mechanical and/or code): Nov 3
- 1st degree of motion: Nov 7
- 2nd degree of motion: Nov 19
- Final Testing/Buffer time/Making things Cleaner/Write up: Nov 26-Dec 6

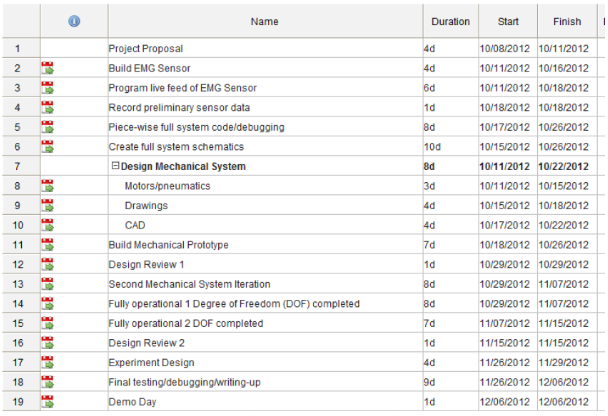

Gantt Chart
Due Dates:
- Proposal due: Thursday, 11 October
- Design Review 1: in-class, Monday, 29 October
- Design Review 2: in-class, Thursday, 15 November
- Thanksgiving Break: November 19-23
- Demo Day: Thursday, 6 December
- Last Class: Thursday, 6 December
- Final Website/writeup due: Monday, 10 December
